VanillaPM
Sign in Get started free Dashboard
P4 People · 33%

Engage stakeholders

In the app: Project → Stakeholders (Overview · Register)

PMP ECO · People (33%) · Task P4. Identify everyone who can affect or be affected by the project, understand them, and engage them deliberately across the whole lifecycle.

Why on-time projects still fail — stakeholders in two minutes

What it is

A stakeholder is any individual, group or organisation that may affect, be affected by, or perceive itself to be affected by the project. The perception part matters: someone who believes they're harmed acts on it, accurate or not.

Engagement is a continuous loop: identify → analyse → prioritise → engage → monitor, repeated as the landscape shifts. In PMBOK® 8e this is the Stakeholders performance domain, one of the eight outcome areas. It is not a kickoff task you finish.

Why it matters

  • Poor stakeholder engagement sinks projects whose schedule and budget were otherwise sound. It is one of the strongest predictors of success.
  • Engaging early surfaces requirements and risks while they're cheap, and builds the political capital you'll spend later clearing obstacles. People support what they help shape.
  • The classic failure is a narrow list: "stakeholders" means the customer, and nobody noticed the regulator or the community who can stop the job.

Where you do it in VanillaPM

Everything lives in the project's Stakeholders workspace:

  • Stakeholders → Register is the list: who they are, their organisation, influence and interest (1–5), current engagement and the owner of each relationship.
  • Stakeholders → Overview turns the register into the Power–Interest grid and the headline counts, including the number of communication channels.
  • Stakeholders → Guideline carries the theory: identification, the grid, the Salience model and engagement levels.

Free download: Stakeholder register template (Excel, CSV).

Walked example — Coral Ridge Resort

Coral Ridge's register spans far more than "the guest". It names the owner, the hotel operator (Corvane), the municipality and the Dept. of Environment (both regulators), the main-contractor JV, the financing bank, the local community and fishers, and the future guests. The community is the one to watch: low formal power, but currently Resistant about beach access, and able to stop work with a protest at the gate. Opponents are stakeholders too. Their concern is logged and owned, not wished away.

The workspace — the theory behind each screen

Each screen below answers one engagement question. Every screenshot is the actual sample project, not a mock-up.


1 · Know who they are, and who owns each relationship

The theory: the stakeholder register. Identification produces a register. For each stakeholder it records identity (name, role, organisation), assessment (power, interest, attitude) and classification. Cast wide: regulators, community, opponents, the team itself.

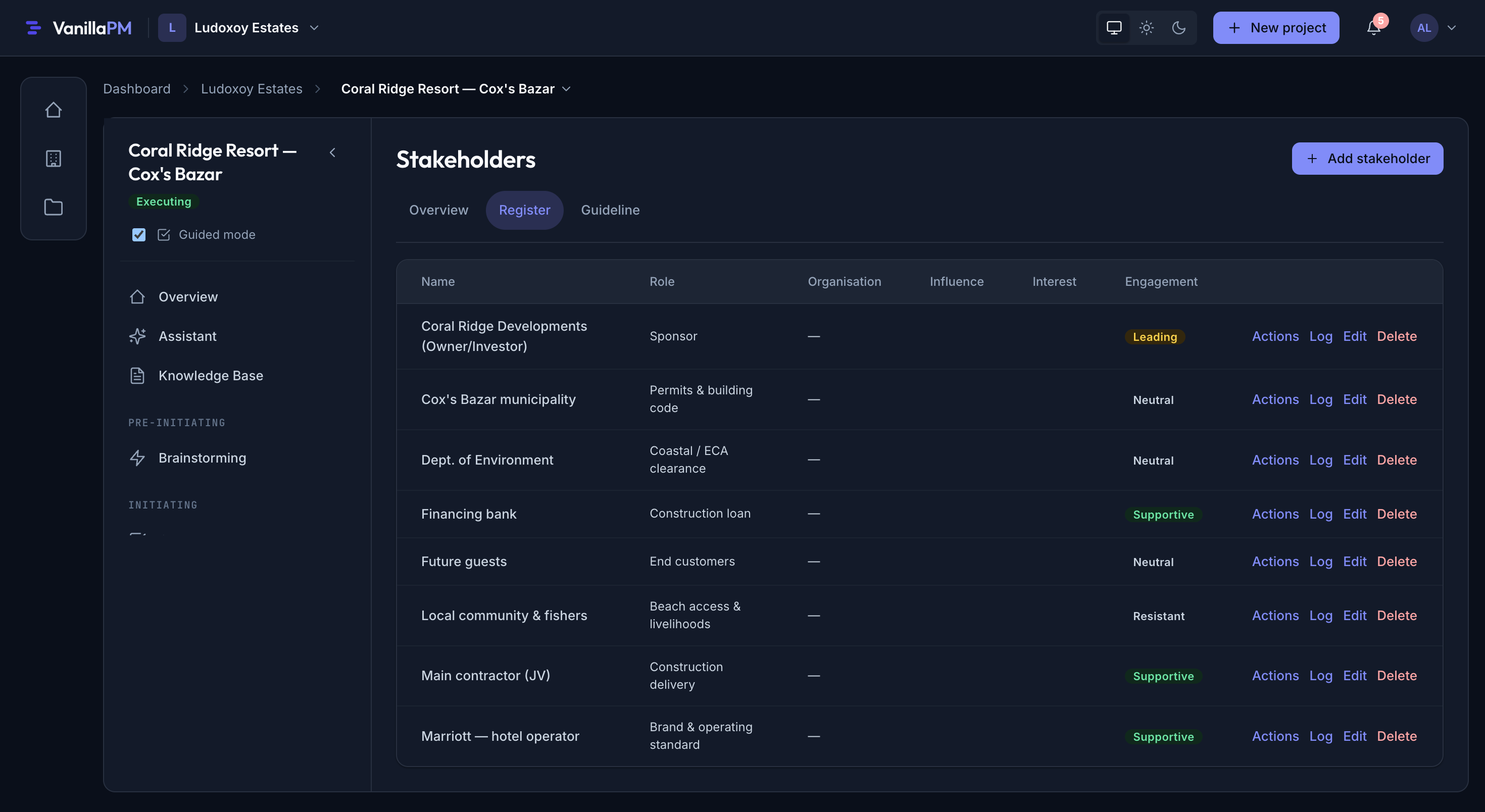

Coral Ridge — the stakeholder register
Coral Ridge — the stakeholder register

Reading the screenshot: eight stakeholders, each with an organisation, influence and interest on a 1–5 scale, the current engagement level, and an owner. Read the Engagement column as now → target: the municipality is Neutral → Supportive, the community Resistant → Neutral. The target is the subject of P5. The Owner column means every relationship has a name against it. When Imran leaves the project, you reassign his three relationships on the register instead of losing them with his inbox.

✅ Do add opponents and regulators on day one, not when they first cause trouble.
❌ Avoid a register with no owners. A relationship everyone owns is one nobody maintains.


2 · Decide how much attention each one gets

The theory: the Power–Interest grid. Plot each stakeholder by power (influence) and interest. The quadrant sets the default strategy:

Quadrant Power · Interest Strategy
Manage closely high · high Key players. Engage fully and often
Keep satisfied high · low Meet their needs; don't bore them with detail
Keep informed low · high Regular information; they often spot problems first
Monitor low · low Light touch; watch for change

For political projects, the Salience model adds a third question: power, legitimacy and urgency. A stakeholder with all three demands attention now. VanillaPM explains Salience on the Guideline; the grid is what it plots.

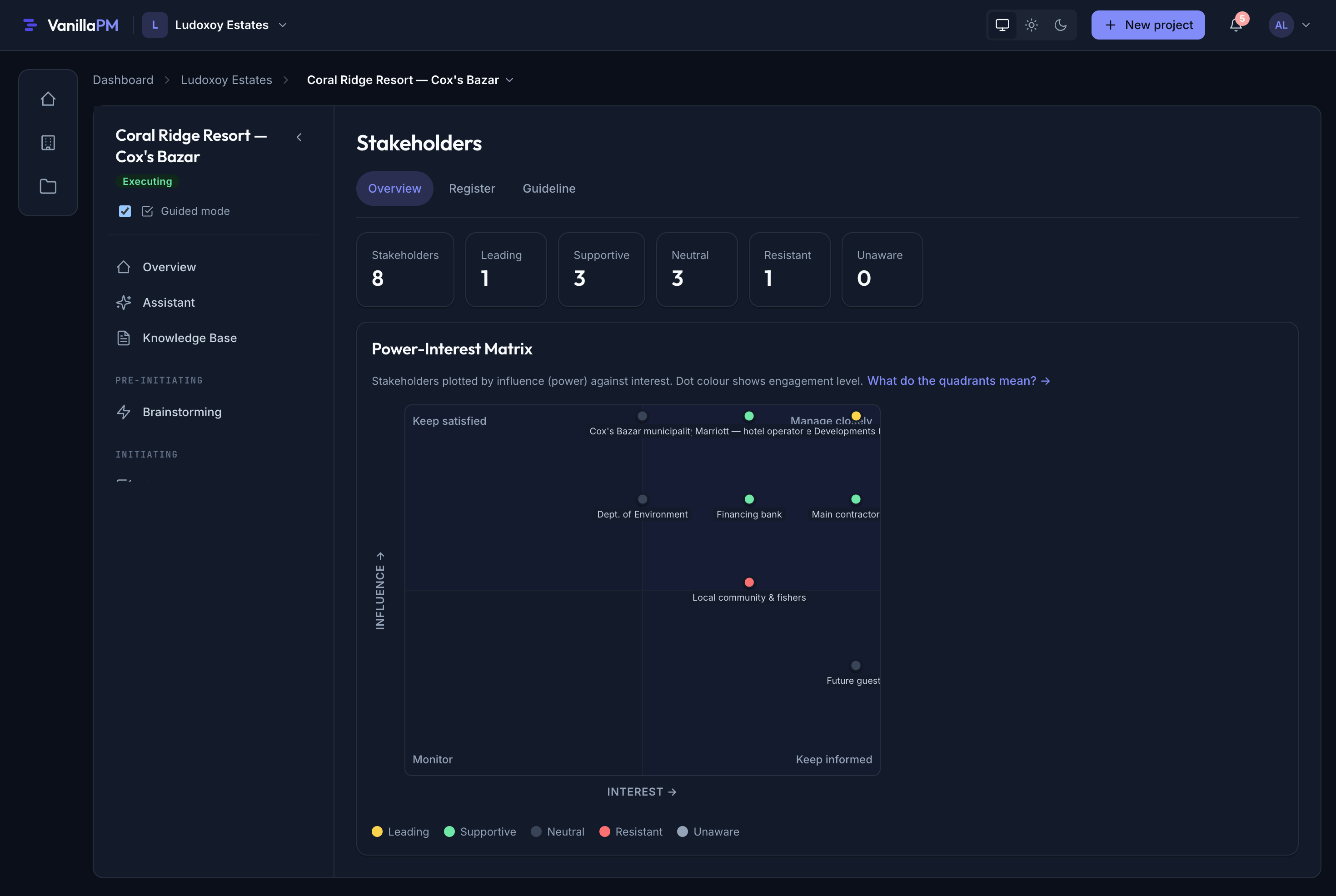

Coral Ridge — the Power–Interest grid with its numbered key
Coral Ridge — the Power–Interest grid with its numbered key

Reading the screenshot: the owner, Corvane, the contractor and the bank cluster in Manage closely. The municipality (3) and the Dept. of Environment (6) sit on the interest midline, and the key places them in Keep satisfied: high power, but their interest is permits and clearance, not the hotel. Now look at 7, the community. The grid says keep informed, but the red dot says Resistant. That's the lesson: the grid sets the default, attitude overrides it. A resistant group with urgency (a protest at the gate) gets more attention than its quadrant suggests, which is exactly what Salience predicts.

✅ Do re-plot after every big event. A new regulator or a community protest moves dots.
❌ Avoid confusing a loud voice with a powerful one. Interest is not influence.


3 · Count the conversations you're signing up for

The theory: communication channels. The number of channels in a group grows with the square of its size: N(N − 1) / 2. Adding stakeholders doesn't add work linearly. It multiplies it.

Coral Ridge — the Stakeholders overview counts
Coral Ridge — the Stakeholders overview counts

Reading the screenshot: 8 stakeholders give 28 channels (8 × 7 / 2). Add a ninth and it's 36: one more stakeholder, eight more channels. The tiles beside it summarise attitude at a glance: one Leading, three Supportive, two Neutral, one Resistant, one Unaware.

✅ Do use the count to justify a communications plan (see P8).
❌ Avoid treating every channel as equal. The grid tells you which ones to invest in.

Best practices & pitfalls

  • Do cast wide: regulators, community, opponents and the team itself.
  • Do treat engagement as continuous; re-scan at each phase.
  • Do give every stakeholder an owner.
  • Do manage perception as carefully as reality.
  • Pitfall: equating stakeholders with "the customer" and missing the regulator or community who can stop the job.
  • Pitfall: reading the grid mechanically and ignoring a resistant, urgent group because its dot sits in a low-power quadrant.

On the PMP exam

The exam treats stakeholder engagement as continuous and proactive. Expect to place stakeholders on the Power–Interest grid and pick a strategy, to know the register is built early but maintained throughout, and to compute channels with N(N − 1)/2 (a new team member on a team of 10 adds 10 channels: 45 → 55). Answers that ignore a powerful regulator or a resistant community, or that engage only at kickoff, are the distractors.

Check your understanding a short quiz — pass to mark the task complete
