Align stakeholder expectations
In the app: Project → Stakeholders (Overview → Engagement assessment matrix · Register → Edit)
PMP ECO · People (33%) · Task P5. For each stakeholder, know where their engagement is and where you need it to be, and close the gap deliberately.
What it is
Once stakeholders are identified and prioritised (P4), alignment is about attitude. PMBOK® names five engagement levels:
| Level | What it means |
|---|---|
| Unaware | Doesn't know about the project or its impact on them |
| Resistant | Aware, and opposed to the project or the change it brings |
| Neutral | Aware, neither supportive nor opposed |
| Supportive | Aware, and in favour |
| Leading | Actively working to make the project succeed |
For each stakeholder you record where they are now (C, current) and where the project needs them (D, desired). That grid is the Stakeholder Engagement Assessment Matrix.
Why it matters
- The gap between C and D is the actionable part. It turns "manage stakeholders" into a short list of specific, owned moves.
- Not everyone needs to love the project. An opponent may only need to reach Neutral so they stop blocking it. Naming a modest target stops you over-investing in one relationship and under-investing in the one that threatens delivery.
Where you do it in VanillaPM
- Stakeholders → Register → Edit sets each stakeholder's current and target engagement, the engagement strategy (the move that closes the gap) and the relationship owner.
- Stakeholders → Overview → Engagement assessment matrix draws the C/D grid from those fields, open gaps first.
- The Register shows the same thing in one column, as current → target.
Walked example — Coral Ridge Resort
Coral Ridge's targets are pragmatic, not uniform:
| Stakeholder | Current | Target | The move |
|---|---|---|---|
| Local community & fishers | Resistant | Neutral | Permanent public beach corridor + local hiring |
| Dept. of Environment | Neutral | Supportive | Monthly ECA monitoring data, before they ask |
| Corvane (operator) | Supportive | Leading | Involve them in fit-out sign-offs |
| Owner / investor | Leading | Leading | Maintain: monthly steering, no surprises |
The community doesn't need to champion the resort. Moving them off Resistant, so the beach-access dispute doesn't stop work, is the win.
The workspace — the theory behind each screen
Every screenshot is the actual sample project, not a mock-up.

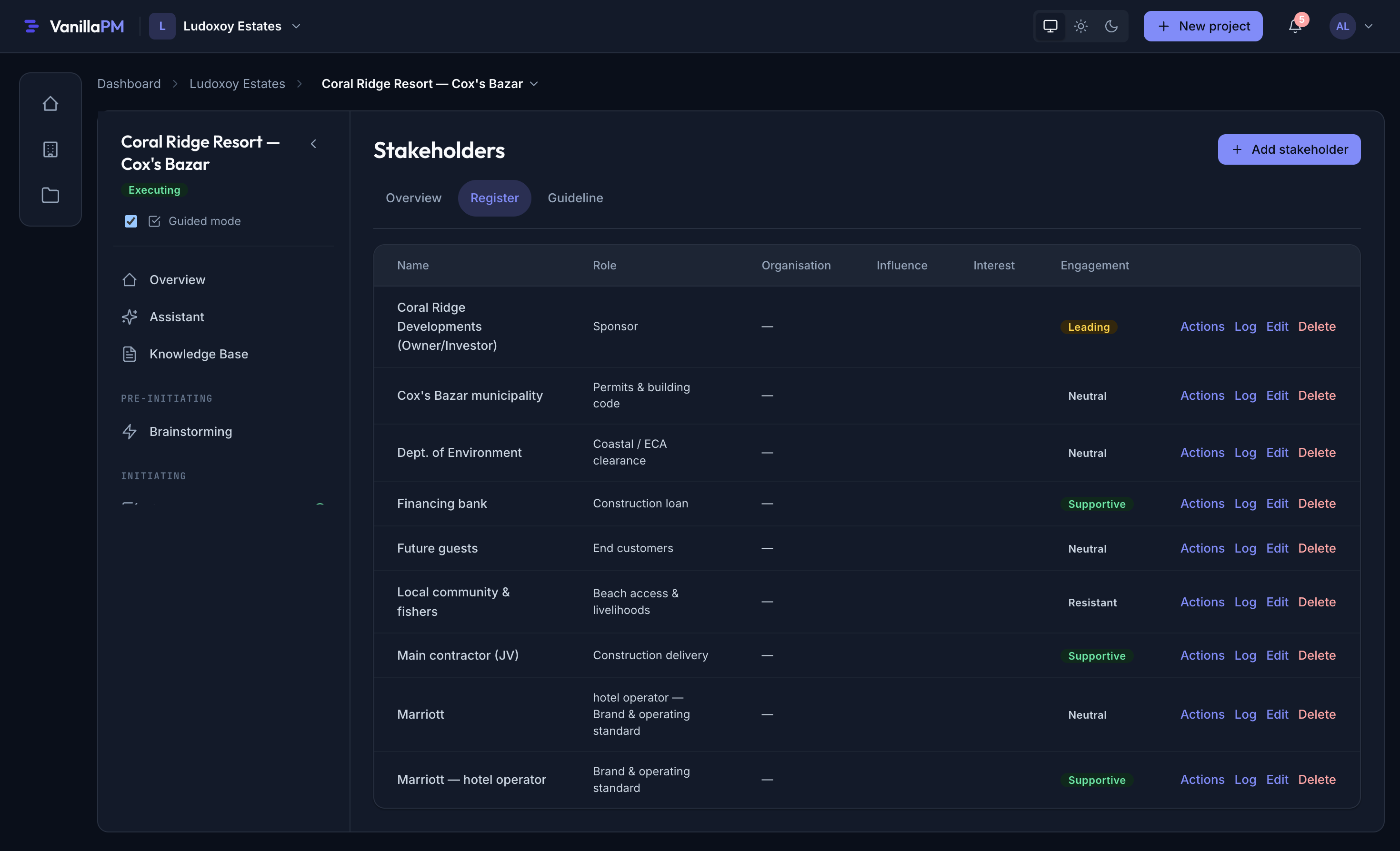

1 · See every gap on one grid
The theory: the engagement assessment matrix. Rows are stakeholders, columns are the five levels. C marks where each stakeholder is, D where you need them. Where C and D share a cell, there's nothing to close, only something to maintain.

Reading the screenshot: five open gaps come first, the most influential at the top, each with its strategy under the name. Four are one level. The largest gap, future guests at two levels (Unaware → Neutral), sits low on purpose: their strategy reads "Not yet", because pre-opening marketing starts six months before opening. Gap size alone doesn't set priority; power and timing do. The last three rows are on target, and maintain is still a strategy: the owner stays Leading only if the monthly steering keeps happening.
✅ Do set realistic targets. Neutral is a legitimate goal for an opponent.
❌ Avoid aiming everyone at Leading. You spread effort thin and miss the gap that matters.
2 · Turn each gap into a specific move
The theory: tailored engagement. A gap closes through an action aimed at that stakeholder's real concern, not a blanket "communicate more". The strategy names the concern and the move.

Reading the screenshot: the community is Resistant, the target is Neutral, and the strategy answers their actual concern, beach access and livelihoods: a permanent public beach corridor plus local hiring, reported back at every town hall. Nadia owns the relationship. The last clause matters most. A commitment nobody reports back on doesn't change an attitude; it becomes the next grievance. Keeping it is P6.
✅ Do write the strategy as concern → move. If you can't name the concern, talk to them first.
❌ Avoid strategies like "keep engaged". They can't be done, so they never are.
Best practices & pitfalls
- Do set realistic targets; "Neutral" is a legitimate goal for an opponent.
- Do rank gaps by power and timing, not by size alone.
- Do re-assess after major events (a clearance granted, a town hall, a rumour).
- Pitfall: aiming everyone at "Leading". You'll miss the one gap that threatens delivery.
- Pitfall: a target with no strategy and no owner. It's a wish, not a plan.
On the PMP exam
Know the five engagement levels and the current-vs-desired matrix. Situational questions often hand you a resistant but powerful stakeholder. The strong answer targets a specific, modest shift and picks an action tailored to their concern, not a blanket "communicate more", and not escalating to the sponsor before you've understood what the stakeholder actually wants.
